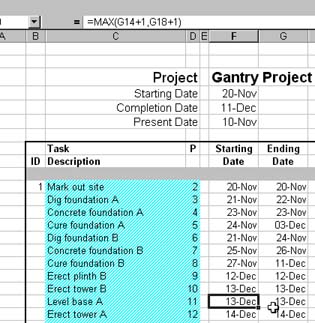

The task to level the base of A is dependent on both plinth B being erected and the cement for A being cured therefore the equation that ProjeX produces for its start date is "=MAX(G14+1,G18+1)", i.e. it cannot start until the end of which ever is greater of the ends of the tasks it is dependent on.

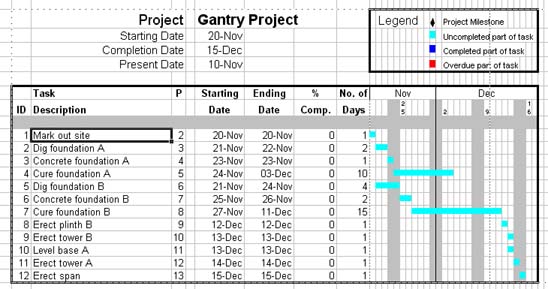

We now have all the dependencies set so we can generate a Gantt chart and all our dependencies will be used.

We can take this one step further and generate and calculate the critical path ...

If we want to look at the Gantt chart on a month by month (or yearly) basis we can use another WAA product PlaneX to plot the tasks.
