Example 2a - Setting task dependencies and finding the critical path

Let's look at how to use ProjeX to build a schedule for a project that has dependencies between tasks - i.e. one task cannot start until another task has finished (or perhaps can only start after another has started).

For this example we will use a simple building project (taken from Quantitative Analysis for Management) involving building a gantry between two points A and B.

Task ID Task Description Duration Prerequisites
1 Mark out site 1 none
2 Dig foundation A 2 1
3 Concrete foundation A 1 2
4 Cure foundation A 10 3
5 Dig foundation B 4 1
6 Concrete foundation B 2 5
7 Cure foundation B 15 6
8 Erect plinth B 1 7
9 Erect tower B 1 8
10 Level base A 1 4, 8
11 Erect tower A 1 10
12 Erect span 1 9,11

Let's say we want the project to start (the marking out of the site) on November 20th we can enter the tasks and durations in ProjeX by first creating a new ProjeX sheet

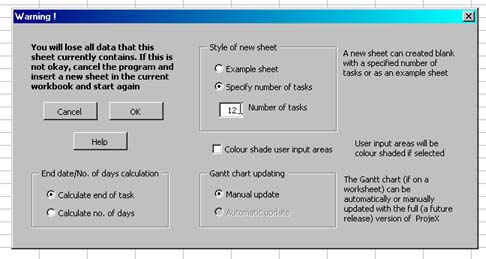

starting it with 12 blank tasks

and adding the task ID number to the left of the task name and also specifying that we want the start dates of the tasks to be specified by their dependencies.



This gives us our basic list of tasks and their durations (in the list below all the starting dates have been set to the start of the project).

We now need to set the dependencies between the tasks ...
